City of Langford | 2017 Annual Report
The City of Langford's 2017 Annual Report covering departmental overviews, results from 2017, objectives for 2018, consolidated financial statements, permissive tax exemptions, and development charge information.
Key facts
- Celebrating the City's 25th anniversary (2017)
- Consolidated Financial Statements included (referenced around p.34)
- Permissive Tax Exemptions section (p.58) and Annual Development Cost Charge (p.63)
- Administration results: Property purchases $1,079,500 and dispositions (proceeds) $1,929,272; 105 active employees as of Dec 31, 2017; 70 bylaws adopted in 2017
City of Langford | 2017 Annual Report
City of Langford Annual Report 2017
Celebrating Our 25th Anniversary!

Langford Corporate Philosophy Statement / Table of Contents
- Langford Corporate Philosophy Statement ............................................................................................................................. 3
- Message From the Mayor ............................................................................................................................................................. 4
- Executive Summary .......................................................................................................................................................................... 5
- Council Standing Committees ....................................................................................................................................................... 6
- Organizational Chart .........................................................................................................................................................................7
- Administration Department ........................................................................................................................................................... 8
(Additional contents continue through Planning, Land Development, Consolidated Financial Statements, Permissive Tax Exemptions, Annual Development Cost Charges.)
Community pride and service excellence through innovation, flexibility and

Message From the Mayor
On behalf of Council, I am proud to share our 2017 Annual Report with you. Since its incorporation in 1992, Langford has strived to become a great place to raise a family, start a business, enjoy recreational opportunities and, learn with its recent push to bring post secondary education to the West Shore.
I am so inspired by the dedication of Council and staff for their hard work in keeping Langford an affordable and family-oriented community. Council has built strong relationships with the development community to ensure that Langford supports affordable housing initiatives and offers a wide-range of housing for all ages and for income levels. Overall construction activity was very vigorous in 2017 with a strong showing in all sectors but with an increase in the multi-family rental area.
Improving and expanding our infrastructure also remains a priority. In 2017, we completed the West Shore Parkway, and in 2018, we completed the Bear Mountain Parkway extension, the dual left turn lane on Millstream Overpass and will complete the connection between Leigh Road and Langford Parkway. All of these projects have come in on time and on or under budget without any increase in taxes. The Engineering Department also completed major drainage improvements on Latoria Road including upgrading driveway culverts on sections of Happy Valley Road.
Council remains tough on crime and focused on community safety. In response to our growing population, we are adding more RCMP officers to ensure that our community, parks and trails remain safe. 2017 saw the retirement of Fire Chief Bob Beckett and the promotion of Chris Aubrey to the position. To ensure a continued rapid response to calls from across our community, the department will be adding more firefighters. Following through with last year’s success, the Bylaw Department has once again retained two summer community safety officers to bike patrol the City parks, beaches and expanding trails network.
We will continue to work with our respective national team partners to make Langford the center of sports excellence in British Columbia. This year’s completion of the Al Charron Rugby Canada National Training centre, as well as hosting the HSBC Women’s Rugby Sevens World Series at Westhills Stadium, the Mountain Bike Canada Cup Series at Bear Mountain and the 2019 National Boxing Championships at Bear Mountain are testaments to this. It is these partnerships, facilities and world class events that help to put Langford on the map, attract visitors to the area and help bring economic diversity to the community.
In closing, I would like to once again express my sincere appreciation to staff for their hard work in delivering Council’s priorities on public safety, affordability, recreation, parks and growing the local economy - all of which serve to make Langford a great place to call home.
Sincerely,
Mayor Stewart Young

Departmental Overview
Administration Department
The Administration Department provides leadership to all City employees, ensures directives from Council are implemented in a timely, cost-effective manner and that all legislative and regulatory requirements of the City are met. The Department supports Council and Committee meetings, including agenda and minute preparation and related issue follow-up and actions. The Department provides advice, assistance and support in all areas relating to recruitment, labour relations, human resources programs, training and development, wage, employee policy, salary administration and any other related matters that involve City employees. The Department also provides administrative assistance to the CAO and Council and coordinates events on behalf of the City and Council.
Building Department
The Building Department provides building permits to residents and contractors who require new construction and alterations, additions, repairs, demolitions, removal or relocations of existing buildings within their property. The Owner(s) of the property is responsible for carrying out the works in full accordance with the requirements of the BC Building Code and other applicable regulations. Inspections are required by the City throughout the construction phase and or upon completion.
Bylaw Enforcement (Community Safety and Municipal Enforcement)
The Community Safety and Municipal Enforcement Department addresses a wide range of issues, ensures the public is well informed of bylaws and assesses risk in our community. They monitor the community so that it remains a safe and enjoyable environment for all. The Department works closely with many agencies to provide the highest level of service.
CRD Animal Control
This service is provided under contract to Langford citizens through the Capital Regional District (CRD) Animal Care Department. The CRD provides a high level of service and communicates regularly with the Community Safety and Municipal Enforcement Department at the City of Langford. This includes regular statistical reporting and collaboration on certain files and activities.
Engineering Department
The Engineering Department serves the public in several aspects of the community including construction activities related to land development, capital projects/public infrastructure, and public works such as road maintenance and repairs, bike lanes, sidewalks and street lighting, as well as the City of Langford’s ongoing beautification project, with hanging baskets and Christmas lights. The Department works closely with West Shore Environmental Services, CRD Water, BC Transit and School District #62.
Fire Rescue
The Fire Rescue Department is a composite fire department made up of career and volunteer members, operating from three stations within the City. The Fire Rescue Department function includes fire suppression, first response, auto extrication, water rescue, rope rescue and technical high angle rescue. The Department provides fire and life safety education, fire safety inspections and fire investigations. Station 1 also houses the CRD Regional Fire Dispatch Centre, established in 2013.
Parks and Recreation Department
The Department is responsible for the Capital construction and Operational maintenance of parks, trails and landscaped boulevards. In addition, the Department oversees activity related to recreation including the maintenance of City recreation facilities.
Planning Department
The Planning Department ensures that municipal goals are reflected in the Official Community Plan and planning policy documents. The Department provides professional and technical advice on current and future land uses, as well as a wide range of issues including housing, heritage, environment, transportation and social policy.
Mayor and Council / Council Standing Committees
- Councillor Lanny Seaton, Chair
- Councillor Roger Wade, Vice-Chair
Parks, Recreation, Culture and Beautification Committee
- Mr. Randy Prettie
- Mr. Morrey Stearns
- Ms. Karen Reece
- Mr. Norman Arden
- Ms. Jennifer Whitehouse
- Mr. Allen Sturgeon
Administration and Finance Committee
- Councillor Matt Sahlstrom, Chair
- Councillor Lillian Szpak, Vice-Chair
- Mr. John Crook
- Mr. David Adair
- Ms. Jennifer Paget
- Mr. Trevor Wan
- Mr. Frank Hudson
Planning, Zoning and Affordable Housing Committee
- Councillor Denise Blackwell, Chair
- Councillor Roger Wade, Vice-Chair
- Ms. Norma Stewart
- Mr. Malcolm Hall
- Mr. David Horner
- Mr. Art Creuzot
- Mr. Kent Sheldrake
- Mr. Steve Harvey
Protective Services Committee
- Councillor Lillian Szpak, Chair
- Councillor Lanny Seaton, Vice-Chair
- Ms. Mitzi Dean
- Mr. Mike Wignall
- Mr. Edward Wilson
- Mr. Hans Frederiksen
- Mr. Rob Crompton
- Mr. Tony Cox
Protective Services Committee (alternate listing)
- Councillor Winnie Sifert, Chair
- Councillor Roger Wade, Vice-Chair
- Mr. Terry Young
- Mrs. Jean Tarr
- Mr. Les Bjola
- Ms. Christine Lervold
- Mr. John Goudy
Transportation and Public Works Committee
- Ms. Dawn E. Helgason
- Mr. Terry Young
- Mr. Hans Frederiksen
- Mr. Jim Hartshorne
- Ms. Rachel Sansom
Board of Variance
- Mayor Stewart Young
- Councillor Denise Blackwell
- Councillor Matt Sahlstrom
- Councillor Lanny Seaton
Economic Development Committee
- Councillor Winnie Sifert
- Councillor Lillian Szpak
- Councillor Roger Wade
- Mr. Hugh MacDonald
- Ms. Mickey Fleming
- Mr. Dan Matthews
- Mr. Jim Hartshorne
- Mr. Gareth Rees
- Mr. David Clarke
- Mr. Dale Gann
- Mr. Michael O’Connor
- Mr. John Wilson
Organizational Chart
Administrator: Darren Kiedyk
Administration Department
- Director of Corporate Services: Braden Hutchins
- Council & Standing Committee Agendas & Minutes
- Bylaws & Policies
- Human Resources
- Freedom of Information
- Property Acquisition & Disposition
- Elections
- Communications
- Bylaw Enforcement
Parks Department
- Parks Manager: Cory Manton
- Parks, Trail & Facility Planning
- Parks, Trail & Facility Construction & Maintenance
- Boulevard Landscape Maintenance
Finance Department and Information Technology
- Director of Finance: Michael Dillabaugh
- Financial Statements
- Insurance
- Investments & Debt
- Security Control
- Budgets
- Accounting
- Payroll
- Accounts Payable
- Tax Collection
- Business Licensing
- Website
- Database
- Local Area Network
- Digital Mapping
Building Department
- Manager, Building Department: Jerry Worobec
- Board of Variance
- Building Plan Review
- Building Permit Issuance
- Building Inspection
- Building Bylaw
- Property File Maintenance
Engineering Department
- Director of Engineering: Michelle Mahovlich
- Roads & Sidewalk Construction & Maintenance
- Sewer Construction & Maintenance
- Streetlights
- Drainage & Flood Maintenance
- Traffic Light & Parking Sign Regulations
Bylaw Enforcement Division (reports to Administration)
- Manager, Community Safety and Municipal Enforcement: Lorne Fletcher
- Public Education
- Enforce City Bylaws
- Conduct Prosecutions
- Community Patrols
- Oversee Animal Control
- Oversee Security Service
- Ensure Processes are Fulfilled
- Mitigate Risk
Planning, Subdivision and Land Development Department
- Director of Planning: Matthew Baldwin
- Official Community Plan
- Zoning Bylaw
- Development Variance Approvals
- Subdivision Approval
- Development Permits
- ALR Referrals
- Liquor Licensing Referrals
- Temporary Use Permits
- Strata Conversions
Fire Rescue Department
- Fire Chief: Chris Aubrey
- Fire & Rescue Response
- Fire Prevention
- Emergency Plan Coordination
- CRD Regional Fire Dispatch
- Emergency Support Services
- Mutual Aid
Other Departments / External Relations
- CRD Board
- CREST
- West Shore Parks and Recreation
- Greater Victoria Public Library
- Regional Water Supply CRD
- Juan de Fuca Water Distribution CRD
Standing Committees
- Administration & Finance
- Parks, Recreation, Culture & Beautification
- Planning, Zoning & Affordable Housing
- Protective Services
- Transportation & Public Works
- Board of Variance
Administration Department — Results from 2017
Council Meetings
| Type | Number |
|---|---|
| Regular Council Meetings | 19 |
| Special Council Meetings | 2 |
| “In Camera” Meetings | 17 |
| Committee of the Whole | 1 |
Committee Meetings
| Committee | Number |
|---|---|
| Planning, Zoning and Affordable Housing | 16 |
| Protective Services | 6 |
| Transportation & Public Works | 2 |
| Administration & Finance | 5 |
| Parks, Recreation, Culture & Beautification | 5 |
Bylaws
| Description | Number |
|---|---|
| Adopted in 2017 | 70 |
| Started in 2017 | 53 |
Types of Bylaws
- OCP Amendments: 5
- Zoning Amendments: 51
- Public Hearings: 45
- Financial: 8
- Regulatory Amendments: 7
- Sewer: 0
- Other: 12
Personnel
- 105 active employees working as of December 31st, 2017
- 1 employee on Long Term Disability in 2017
- 28 new employees recruited in 2017
Property
- Property Purchases - $1,079,500
- Property Dispositions - $1,929,272 (proceeds)
Building Department
Overall construction activity in Langford was very vigorous in 2017. All sectors were strong and consistent compared to 2016, with the greatest increase showing in the Multi–Family rental area. Economic activity was prevalent in commercial sectors, with Sobey's site underway. The Building Department continues to promote economic development by providing streamlined Building Permit services as well as public health and safety through the application and enforcement of the building codes and Standards.
Objectives and Measures for 2018
In 2018 the Building Department will continue to:
- Promote economic development through the expedited permit process for 1 and 2 SFD’s
- Continually work with Development teams on larger projects to ensure efficient reviews and issuance of permits
- Promote public health and safety through the application and enforcement of the building codes and standards:
- Promote the understanding of building regulations by assisting and supporting the development community through the next code cycle of change; and
- Measure success by the degree to which the building department enables building activity in Langford while still holding paramount the safety, health, and welfare of the public.
Bylaw Enforcement (Community Safety and Municipal Enforcement)
Our officers were tasked with addressing complaints and violations of City Bylaws in the areas of noise, parking, land use, building, soils movements, watercourse protection and burning regulations. We also played a significant role in providing enhancements to community safety by assisting the Fire Department and the West Shore RCMP at a number of emergency incidents like motor vehicle accidents, structure fires, gas line breaks and others, mainly by providing traffic and roads controls.
Our strong efforts at dealing with incidents of public dumping on City lands and our dealings with graffiti and other forms of vandalism continued to keep Langford tidy and clean to a standard most residents approve of and enthusiastically appreciate.

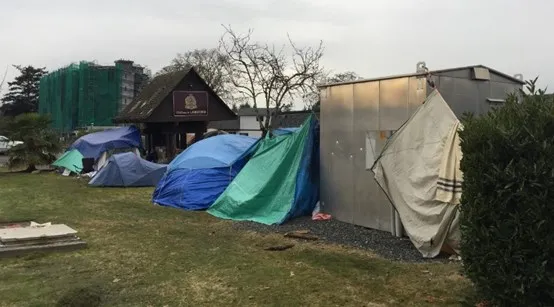

Homeless Camp — As was experienced by other communities through the Capital Region in 2017, Langford received a visit from the roving group of protesters whose goal was to increase public awareness around homeless issues. The group of approximately ten campers and tents arrived in Langford in late December and the camp grew in the days following. This visit went smoothly over the two and a half weeks which we attribute to the fact that our City staff met with and engaged the protest group in discussions prior to, and regularly during their stay.
Staff also assisted in identifying a site that could satisfy the group’s high traffic and visibility needs for delivering their message. Our Community Liaison Officers reached out to the operators of nearby businesses in advance to alert them to the visit, its purpose and anticipated duration. The Bylaw Enforcement Department fielded a number of inquiries and addressed incoming public concerns. Once the group moved on to Central Saanich at the end of December, we again followed up with those same nearby business operators to obtain feedback - which we found to be quite positive overall.
Parks and Trail Patrols — Our department delivered another very rewarding and safe summer to our residents, particularly within the scope of the bike patrols of City parks, beaches and the expanding trails network. The significance of this community safety presence to the public was frequently commented on as park and trail users thanked our officers for being out with watchful eyes within these public spaces.
Fig. 1: 2017 Bylaw Enforcement Departmental Activity by Complaint Type
(Figure displayed in original report)
- Refer to figure for complaint type breakdown. (Caption: Fig. 1: 2017 Bylaw Enforcement Departmental Activity by Complaint Type)
CRD Animal Care Services
DEPARTMENT OVERVIEW and RESULTS FROM 2017
(The document lists animal-related complaint/response categories and a comparison between 2017 and 2016. Original layout preserved:)
2017 2016
65
Livestock
At large
Attack – Livestock
Barking
Licence
Excrement
Safe Keeping
0 1
9 3
Dogs
4 3
5 2
11
4 2
Return to Owner 68 55
3
To rescue agency
(See original report pages for formatted presentation of CRD Animal Care statistical details.)
Engineering Department
DEPARTMENT OVERVIEW
The Engineering Department consists of two areas of operation: Construction and Public Works.
The construction group is responsible for overseeing capital construction projects such as the West Shore Parkway Completion Project and the Millstream Overpass Improvements, as well as construction related items for land development/subdivision projects. Construction staff are also responsible to oversee upgrades or replacements for such items as culverts.
Public works staff are responsible for overseeing ongoing road maintenance including storm water control, road quality, sidewalks, bike lanes and streetlights. Public works staff are also responsible for outside beautification items such as hanging baskets and Christmas lights.
Results from 2017
2017 Sewer Construction (West Shore Environmental Services)
- Sewer System
- Designed and tendered the Bray Avenue and Carlow Road sewer extension.
- Began construction of the Jacklin Road and Terlane Avenue sewer extension under the direction of the City of Langford and the Belmont Market Project.
- Completed mainline sewer extensions for 881 Klahanie, Kiwi Road, 2807 Sooke Lake Road, 2822 Knotty Pine Road and 2566 Wentwich Road.
- Signed a mainline sewer extension agreement for Lakehurst Drive, Mount Wells Drive and Sooke Lake Road sewer extension.
- Received approximately 503 new connections (SFE) to the Langford sewer system, including 71 mandatory connections consisting of 48 paying SCRF’s and 23 non-paying in existing SSA’s.
- 23 individual sewer services constructed, including 4 disconnects.
- Attended 3 sewage overflows in 2017 including an air valve failure near Crystalview Terrace, a LPS pipe break near Shoreview Drive and a pipe blockage in the Coralee Place area.
- Continued update to the 2008 Sewer Master Plan.
- Continued updating and maintenance of digital GIS sewer database.
- Inflow and Infiltration Program
- 71 sewer manholes inspected for inflow and infiltration
- Rehabilitated 46 sewer inspection chambers.
- 4.5 km of sewer main CCTV videoed; approximately 850 m of main power flushed and cleaned.
- CCTV video uncovered two areas where the lines had significant root intrusion, appropriate repairs were completed.
- Pump Station Upgrade and Maintenance
- Completed annual maintenance and servicing of all pumping equipment including 4 pump rebuilds, and a few miscellaneous impeller adjustments, to increase pump output.
- Rebuilt 5 pump flush valves.
- Completed annual maintenance and servicing of all electrical controls and equipment. Tested all UPS backup power supply systems with power failure simulations resulting in 3 stations needing repair or replacement of some in-kiosk electrical control/backup up components.
- Completed annual load testing and servicing of all 7 standby generators. One repair completed for the oil pressure monitoring system at the Selwyn Station.
- Tested all backflow preventers, no repairs were required in 2017.
- Replaced 2 air release valves on sewer force mains.
- Completed tear down and rebuild of the Langford Parkway electric plug valve controlling flow from the overflow to the wet-well.
- Began upgrade of SCADA system from NI Lookout (now unsupported) to VTScada program.

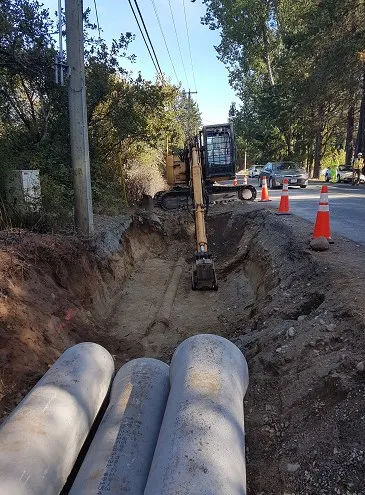

Storm Drainage

Capital
- Completed major drainage improvements on Latoria road including upgrading driveway culverts from 954 Latoria Road west to Happy Valley Road, south down Happy Valley Road to 3569 Happy Valley Road.

Maintenance
- Completed annual storm water pond maintenance removing invasive species, weeds and any blockages as necessary in all storm water ponds.
- Completed stream and culvert inspections and cleared debris as necessary.
- Installation of several rock pits on road edges for the annual rock pit program to improve roadside drainage in older established areas of the City.
Roadworks
Capital
- 3.5km West Shore Parkway extension project linking the Trans Canada Hwy to Sooke Road
- Millstream Overpass Improvements that included a second southbound left turn lane, east side pedestrian improvements, bike lanes over the overpass in both directions
- Dunford Avenue bike lanes
- Orono Avenue repaving and stormwater improvements
Operating
- Took 5.4 km of new sidewalk into inventory
- Gained 9.1km of bikelanes
- Gained 8.0km of roads
- Increased sign inventory by over 300 signs
Maintenance
- Completed annual Road Crack Sealing Program.
- Completed annual Pothole/Pavement Repair Program.
- Undertook sidewalk inspections and repairs as necessary.
Objectives and Measures for 2018
In 2018, the Engineering Department will continue to:
- Complete capital construction projects in accordance with the approved Annual Budget,
- Maintain City infrastructure, and
- Beautify the City.
Fire Rescue Department
DEPARTMENT OVERVIEW
Fire Rescue Service provides 911 emergency response and acts as the first point of contact with residents and visitors for many incident types. Fire and life safety education, directed at a wide variety of community demographic and social groups, provide valuable information and exposure to the dangers of fire and other hazards as well as methodologies to prevent or minimize damage and injury. Direct contact and influence are provided to citizens and businesses through related bylaw enforcement, legislated fire safety inspection at public and commercial properties, during formal fire investigations and within the pre-incident planning process.
The core of the Department remains a highly dedicated and trained group of volunteer firefighters. They perform all aspects of department operations related to fire suppression and public education. The volunteer firefighters are supplemented by a career staffing contingent of 8, responsible for department management and supervision, inspections, training, public education and operational readiness. An administrative assistant provides technical and administrative support to all members of the Langford Volunteer Firefighters Association (LVFA) as well as to the Emergency Support Services (ESS) volunteers, the Women’s Auxiliary and the Amateur Radio Group.
RESULTS FROM 2017
- Chief Bob Beckett retired on June 16, 2017 which allowed for the promotion of Asst. Chief Chris Aubrey.
- Capt. Lance Caven filled the Asst. Chief vacancy and Graham Arnold was hired as a Firefighter and began work in September 2017.
OBJECTIVES AND MEASURES FOR 2018
- Chief Aubrey has been working to build positive relationships with neighbouring departments such as Metchosin, Sooke, Colwood and View Royal and developing ways in which the local departments can work more cooperatively. Incidents such as wildfires can easily spread over municipal boundaries and therefore, there are advantages to the local departments aligning training and operational guidelines to be better able to work together during a regional event. This is also true for BCAS and the RCMP and efforts to develop stronger relationships with these organizations are ongoing as well.
- Emergency Support Services has received a grant to conduct a reception center exercise to prepare for a local evacuation similar to what occurred in the interior in 2017. A number of Langford ESS volunteers deployed to the interior during the fires and the lessons learned from that experience will help the rest of the team prepare should Langford face an emergency that would result in a large scale evacuation. The exercise will assist in identifying areas in our operations and planning that can be updated to adjust for things that went well with the interior evacuations and ways we can improve.
Incidents Per Year (from graphic in original report):
- 2013: 1479
- 2014: 1594
- 2015: 1737
- 2016: 1645
- 2017: 1848

Parks and Recreation Department
DEPARTMENT OVERVIEW
The Al Charron—Rugby Canada National Training Centre continued construction throughout 2017 with occupancy and completion in December. This building houses three national teams and provides the necessary resources to keep the athletes at their highest performance. 2017 also saw the replacement of the Artificial Turf Field at Westhills Stadium. We continue to witness international events at the stadium with the America’s Cup Men’s event and World Rugby Womens’ Sevens event each year. Many smaller projects were completed and we added Tara McLellan as the Landscape Design Technician and said goodbye to Mike Leskiw as the Parks Manager.
Results from 2017
Development of Land Development Referral/Inspection Processes
Working in conjunction with Engineering, Planning and Land Development Departments, Parks staff review and approve all landscaping on public lands. An emphasis on the development of processes to improve the inspection and tracking of these developments from the Parks Department has been undertaken to ensure a more efficient involvement and ultimately, the timely completion, of the development.
Highlights of Completed Projects in 2017
- Veterans Memorial Park
- Feb 2017— The installation of a safer rubber base to the swing area.
- Mar 2017—Coloured lights were installed in the pond/fountain.
- Trans Canada Trail Signage
- June 2017—New directional signage was completed along the trail. This was in part due to the successful grant application requested by the department and received from the Federal government.
- Westhills Arena
- April 2017— Mold remediation was required due to condensation involving the metal trusses/beams and the insulation.
- Artificial Turf Replacement— Westhills Stadium Field
- July 2017— The typical shelf life for this type of field is 8-10 years. Due to good maintenance practices, we were able to extend the use of the previous field to it’s maximum expectation.
- Centennial Park—Resurfacing of Tennis Courts
- Aug 2017—The tennis courts required a substantial resurfacing due to heavy use and tree root intrusion causing the asphalt to break.
- Well Registration and Repairs/New Installation
- Sept 2017—Due to new provincial requirements, the City was required to register the irrigation of wells throughout the City. Upon inspection, it was determined that several of the wells required repair.
- Dec 2017—There was a new well installed at the Al Charron/Rugby Canada Training Centre.
- Glen Cove Park—Replacement of Ramp and Relocation of Swimming Float
- Oct 2017—The fishing wharf was moved from the original location to the beach area and a new aluminum ramp was constructed to connect the float to the shore. This provides access to the float for a wider range of user groups and improves sight lines to alleviate vandalism and related activities at the previous location. The old ramp was removed and the trail decommissioned.
- Veterans Memorial Park—Vimy Ridge Tree Planting
- Oct 2017— A sapling was planted at the park as part of the 100 Centenary commemorations of the Battle of Vimy Ridge. The sapling is a descendant of acorns that were collected from Vimy Ridge by a Canadian soldier who fought during this battle.
- Al Charron/Rugby Canada Training Centre
- Dec 2017—This greatly anticipated state-of-the-art facility was finally completed in December 2017 and the Grand Opening took place on February 27, 2018.

2017 Events at City Centre Park and Venues
Eagle Ridge Community:
- Feb 3-5 Victoria Disability Bocce Tournament
- Mar 25 Crusher Combat
- Mar 30-Apr 1 Quilters Guild
- Apr 6-9 Victoria Kids Consignment Sale
- Apr 16 Annual Easter Event
- Apr 26-27 Slegg Lumber Show
- Jun 17 Crusher Combat
- Sep 30 Rotary Club—Chili Cook-off
- Oct 7 Crusher Combat
- Oct 13-15 Victoria Kids Consignment Sale
- Nov 24-25 Magic of Christmas Event
- Dec 1-2 SIFPA Christmas Event
- Dec 9 Sleep Country/Family Corp Christmas Party
- Dec 16 Schneider Electric Family Corp Christmas Party
Goudy Field:
- Jun 9 Peninsula Co-op Family Day
City Centre Grill:
- Apr 13 Bubble Hockey Tournament
- Apr 27 Bubble Hockey Tournament
- May 4 Bubble Hockey Tournament
- May 13 Nascar “GO BOWLING 400”
Langford Lanes:
- Oct 31 Halloween Bowling Event
- Nov 3-4 Pro Am Bowling Tournament
Westhills Arena:
- Jan 21-22 Pacific Cup Tournament
- Feb 11-13 JDFMHA Hockey Tournament
- Feb 24-26 PCHA Showcase
- Mar 18-20 Debbie Cooper Tournament
- Nov 10-12 JDF Minor Hockey Tournament
- Dec 3 Skate with Santa
- Dec 10 Canada 150 Skate Day
- Dec 27-31 JDF Minor Hockey Tournament
Westhills Stadium:
- Feb 3-11 Americas Rugby Championships
- Mar 17-18 National University 7s
- May 27-28 Canada Sevens Women's 7s World Series
- Jun 4 Goddess Run
- Jun 11 JDRF Telus Walk to Cure Diabetes
- Aug 19 Rebels Vs Kamloops Broncos
- Aug 26 Rebels vs Chilliwack
- Sep 2 Langford 7s
- Sep 9 Rebels vs Kamloops Broncos
- Sep 16 Rebels vs Van Island Raiders
- Oct 7 Rebels vs Okanagan Sun
Miscellaneous:
- Dec 15-17 Christmas Lights Trolley Tours—Loading Zone WH Arena
- Dec 16 CGI Christmas Party—Playzone/Outdoor Ice
Objectives and Measures for 2018
- Construction and maintenance of parks and major facilities as outlined in the budget
- Continue to look for grant opportunities for trail, playground and stadium expansion
- Promote Langford as a national sport organization and recreation destination
Planning Department
DEPARTMENT OVERVIEW
The Planning Department is responsible for the administration of current and long range planning for the City of Langford. Current planning addresses development and day-to-day land use issues, including zoning, development permits and development variance permit applications. Long range planning addresses changes to the City’s Official Community Plan and land use regulations. The Planning Department includes the Land Development Division, which is responsible for subdivision approvals. The Planning Department also assists the Parks Department with long range park planning.
Results from 2017
- Centre Mountain Municipal Boundary Adjustment: The Province of British Columbia adjusted the municipal boundary between the City of Langford and the District of Metchosin, reducing the area (generally known as Centre Mountain) within Metchosin’s boundary by approximately 150 ha (380 acres) and placing those lands within the City of Langford. This boundary adjustment was also being supported and advanced by the Beecher Bay First Nation as part of their ongoing treaty settlement process with the Province.
- Rental Housing: In addition to the 229 rental apartment units authorized by Development Permit in 2015 that are now either occupied or nearing occupancy, 174 rental apartment units were authorized by Development Permit in 2016. Since 2001, approximately 764 new rental apartment units have been constructed, or are currently under construction. The majority of these are in the City Centre.
- Redefinition of the City Centre: The Planning Department proposed a broader definition of Langford’s City Centre in the Official Community Plan which was adopted by bylaw in early 2018. In conjunction with this, the City has also engaged Professor Avi Friedman of McGill University and his staff to prepare a vision for Downtown Langford which will include new design guidelines for development in Downtown Langford, and ultimately help grow and shape the future of Langford’s core.

Type of Application — In Process / Issued/Adopted This Quarter
| Type of Application | In Process | Issued/Adopted This Quarter |
|---|---|---|
| Agricultural Land Commission | 3 | 1 |
| Development Permits* | 25 | 23 |
| Sign Development Permits | 13 | 10 |
| Development Variance Permits | 12 | 6 |
| OCP Amendments | 4 | 2 |
| Temporary Use Permits | 0 | 0 |
| Zoning Amendments | 36 | 9 |
| TOTAL | 93 | 52 |

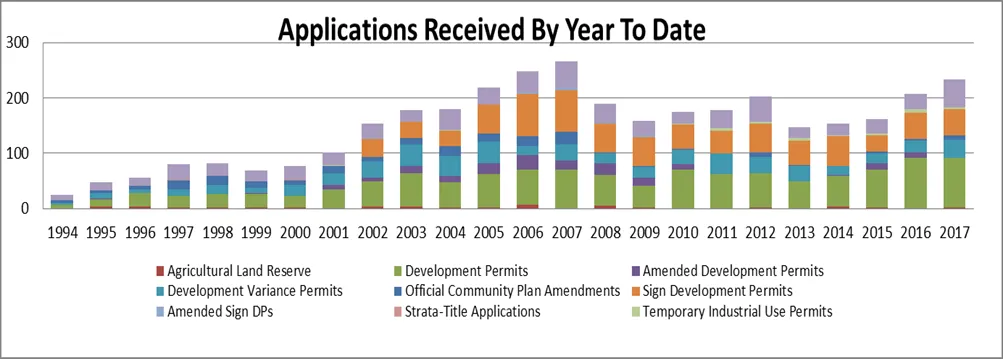

Applications Received in 2017
Development, ALR, DP, DVP, LLP, SDP, OCP, TUP, Zoning — Full Listing
(The following table reproduces the Applications Received in 2017 as presented in the report. Columns: #, Application, Received, Issued, Location, Proposal.)
| # | Application | Received | Issued | Location | Proposal |
|---|---|---|---|---|---|
| 1 | ALR-17-01 | 20-Jan-17 | Denied | 940 and 960 Latoria Rd | Exclusion for School (whole properties) |
| 2 | ALR-17-02 | 1-Aug-17 | 940 and 960 Latoria Rd | Exclusion for School (portions of) | |
| 3 | DP-17-01 | 6-Jan-17 | 26-Jan-17 | 1045 Goldstream Ave | Form & Character - Construction of a new Duplex |
| 4 | DP-17-02 | 9-Jan-17 | 8-Feb-17 | 850 Langford Pkwy | Form & Character - Rona conversion to Lowe's |
| 5 | DP-17-03 | 16-Jan-17 | 8-Mar-17 | 2822 & 2824 Knotty Pine Rd | Form & Character - Townhouse Development |
| 6 | DP-17-04 | 17-Jan-17 | 18-May-17 | 2131, 2160, 2181 & 2251 Bear Mountain Pkwy | Environmental - Site Clearing for staging of construction equipment and storage of aggregate |
| 7 | DP-17-05 | 16-Jan-17 | 27-Apr-17 | 1189 Goldstream Ave | Environmental - Addition in a Riparian area |
| 8 | DP-17-06 | 17-Jan-17 | 23-Apr-17 | 2326 & 2350 Millstream Rd | Form & Character - Two 6-Storey Apartment Bldgs; One 72-Units and One 60-Units |
| 9 | DP-17-07 | 24-Jan-17 | 23-Mar-17 | 2895 West Shore Pkwy | Form & Character - 2nd Office and storage space |
| 10 | DP-17-08 | 27-Jan-17 | 21-Apr-17 | 1109 Braeburn Ave | Form & Character - 7 Townhouse Units |
| 11 | DP-17-09 | 14-Feb-17 | 30-Mar-17 | 1175 Natures Gate, 2190 & 2220 Spirit Ridge Dr | Environmental for 38 Lot Subdivision |
| 12 | DP-17-10 | 10-Apr-17 | 19-Jul-17 | 3296 Jacklin Rd | Form & Character - 2 Small Lots and 10 Townhouse Development |
| 13 | DP-17-11 | 22-Feb-17 | 22-Mar-17 | 2975 & 2979 Amy Rd | Form & Character - Duplex with No Suites |
| 14 | DP-17-12 | 22-Feb-17 | 13-Mar-17 | 1306 & 1308 Champions Crt - Lot 17 | Form & Character - Duplex |
| 15 | DP-17-13 | 6-Mar-17 | 20-Apr-17 | 1219 Goldstream Ave | Environmental - Extend Existing Deck |
| 16 | DP-17-14 | 7-Mar-17 | 18-Apr-17 | 2913 Kettle Lake Dr & 3300 Kettle Creek Cres | Form & Character - 112 Townhouse Unit Development |
| 17 | DP-17-15 | 8-Mar-17 | 8-Mar-17 | 2880 West Shore Pkwy | Environmental - Soil Deposition |
| 18 | DP-17-16 | 15-Mar-17 | 13-Apr-17 | 667 Redington Ave | Form & Character - Two Five-Storey, 50 Unit Apartment Buildings |
| 19 | DP-17-17 | 15-Mar-17 | 23-Mar-17 | 2309 Echo Valley Dr | Form & Character - 47 Unit Townhouse Development |
| 20 | DP-17-18 | 15-Mar-17 | 23-Mar-17 | 2131, 2160, 2181 & 2251 Bear Mountain Pkwy | Environmental - Site Clearing for Staging of Construction Equipment and Storage of Aggregate |
| 21 | DP-17-19 | 24-Mar-17 | 23-Jul-17 | 3130 Jacklin Rd | Environmental DP - Land Clearing and Form & Character |
| 22 | DP-17-20 | 24-Mar-17 | 11-Apr-17 | 1431 Grand Forest Close | Environmental DP - Additional Development |
| 23 | DP-17-21 | 31-Mar-17 | 21-Apr-17 | 3650 Happy Valley Rd | Form & Character - New Childcare Facility |
| 24 | DP-17-22 | 31-Mar-17 | 24-Apr-17 | 1080 Jenkins Ave | Form & Character - 2 Duplexes |
| 25 | DP-17-23 | 5-Apr-17 | 25-Apr-17 | 3097 West Shore Pkwy | Environmental - Water Main Installation |
| 26 | DP-17-24 | 6-Apr-17 | 2-May-17 | 1449, 1456, 1454, 1469, 1484 Pebble Pl | Form & Character - Amendments DP16-36 (shingles) |
| 27 | DP-17-25 | 10-Apr-17 | 18-Jul-17 | 616 Goldstream Ave | Form & Character - 73 Housing Units |
| 28 | DP-17-26 | 13-Apr-17 | 11-May-17 | 1023 Loch Glen Pl | Environmental - House Reno and Variance |
| 29 | DP-17-27 | 25-Apr-17 | 17-May-17 | 849 Station Ave | Form & Character - Canada Post Building |
| 30 | DP-17-28 | 25-Apr-17 | 1177 Goldstream Ave | Environmental - Triplex | |
| 31 | DP-17-29 | 25-Apr-17 | Closed | 4397 West Shore Pkwy | Environmental - Re-Routing of Hydro |
| 32 | DP-17-30 | 3-May-17 | 4-Jul-17 | 2980, 3000 Irwin Rd, 1220 Parkdale Dr | Environmental - Construction of a Drainage Ditch |
| 33 | DP-17-31 | 4-May-17 | 2-Aug-17 | 3003 Irwin Rd, Westhills Nova Lands Phase 6 | Form & Character - 34 Lots, 85 Units |
| 34 | DP-17-32 | 5-May-17 | 12-Jun-17 | 3059 and 3061 Jacklin Rd | Amendments DP16-30 - Phase 1 Commercial |
| 35 | DP-17-33 | 18-May-17 | 1018 Fashoda Pl | Form & Character - 6 SFDs | |
| 36 | DP-17-34 | 25-May-17 | 27-Jun-17 | 1307 and 1312 Champions Crt | Form & Character - 2 Duplexes |
| 37 | DP-17-35 | 25-May-17 | 20-Oct-17 | 2041 and 2045 Country Club Way | Form & Character - 2 Units Condo |
| 38 | DP-17-36 | 29-May-17 | 19-Oct-17 | 2839 Jacklin, 862, 864, 866 Orono Ave | Form & Character - 2 Rental Buildings |
| 39 | DP-17-37 | 1-Jun-17 | 29-Sep-17 | 694 Hoylake Ave | Form & Character - 10 Townhouse Units |
| 40 | DP-17-38 | 8-Jun-17 | 17-Jul-17 | 1297 Glenshire Dr & 2929 Sooke Rd | Environmental - Site Preparation, Blasting |
| 41 | DP-17-39 | 20-Jun-17 | 21-Jul-17 | 2741, 2749, 2751, 2753, 2757, 2761 Spencer Rd and 996 Preston Way | Mixed Use Building of 63 Rental Units with Office Space and Studio/Daycare |
| 42 | DP-17-40 | 23-Jun-17 | 20-Jul-17 | 2762 & 2768 Claude Rd | 11 Storey Rental Apartment Building |
| 43 | DP-17-41 | 22-Jun-17 | 25-Sep-17 | 2926 Leigh Pl | Environmental - Riparian for a New SFD |
| 44 | DP-17-42 | 29-Jun-17 | 20-Jul-17 | 892 Goldstream Ave | Form & Character - Additional Work Bay, Revised Landscaping Plan, and Minor Building Revisions |
| 45 | DP-17-43 | 5-Jul-17 | 26-Jul-17 | 3039 Glen Lake Rd | Form & Character - Carriage House |
| 46 | DP-17-44 | 10-Jul-17 | 2-Oct-17 | 3003 Irwin Rd - Westhills Nova Lands Ph 7B | Environmental - Amend the Boundary to Allow for Additional Residential Lots |
| 47 | DP-17-45 | 10-Jul-16 | 18-Aug-17 | 3003 Irwin Rd - Westhills Nova Lands Ph 7a | Form & Character - Westhills 7A - 27 Lot Subdivision |
| 48 | DP-17-46 | 12-Jul-17 | 31-Jul-17 | 721 Station Ave | Form & Character - Re-Clad a portion of the façade, namely the sign parapet |
| 49 | DP-17-47 | 12-Jul-17 | 3-Oct-17 | 2824 Knotty Pine Rd | Form & Character - Amends DP-17-03 |
| 50 | DP-17-48 | 12-Jul-17 | 23-Oct-17 | 2285 Bellamy Rd | Form & Character - Frontage Improvements and Landscaping |
| 51 | DP-17-49 | Not Applied for | 11-Sep-17 | 2614 Sooke Rd | Form & Character - 4-Storey Commercial Office Bldg |
| 52 | DP-17-50 | 21-Jul-15 | 18-Oct-17 | 2023 Millstream Rd | Form & Character - Non-permanent installation of Tension Fabric Building and Modular Container |
| 53 | DP-17-51 | 12-Dec-15 | 5-Dec-17 | 767, 769 & 771 Hockley Ave (765 Hockley - new address) | Form & Character - 6-Storey Apartment Building |
| 54 | DP-17-52 | 29-Jan-16 | 20-Sep-17 | 3059 & 3061 Jacklin Rd; 3008 Brittany Dr | Form & Character - 2 Mixed Use Buildings with 156 Units Above Commercial |
| 55 | DP-17-53 | 22-Aug-17 | 2636, 2640 & 2646 Peatt Rd; 808, 812 & 820 Arncote Ave; 2641, 2647 | Form & Character - 12-Storey - 222 Units | |
| 56 | DP-17-54 | 21-Feb-17 | 10-Nov-17 | 1256 Landing Lane | Form & Character - 2 Condominium Buildings |
| 57 | DP-17-55 | 1-Sep-17 | 2251 Bear Mountain Pky | Environmental for Site Clearing | |
| 58 | DP-17-56 | 7-Sep-17 | 11-Oct-17 | 1069 Trillium Rd | Environmental - SPEA |
| 59 | DP-17-57 | 12-Sep-17 | 5-Oct-17 | 2150 Millstream Rd (Lot 8) | Form and Character - Duplex |
| 60 | DP-17-58 | 14-Sep-17 | 3-Nov-17 | 2780 Veterans Memorial Pky | Form and Character - Day Care Reno |
| 61 | DP-17-59 | 21-Sep-17 | 16-Oct-17 | 2150 Millstream Rd (Lot 9) | Form and Character - Duplex |
| 62 | DP-17-60 | 27-Sep-17 | 29-Sep-17 | 3130 Jacklin Rd | Amends DP17-0019 |
| 63 | DP-17-61 | 27-Sep-17 | 1345 Ravensview Dr | Environmental - Building for Storage of Materials and Equipment | |
| 64 | DP-17-62 | 27-Sep-17 | 23-Nov-17 | 731 Station Ave | Form & Character - 60 Unit Development With Ground Floor Commercial Space |
| 65 | DP-17-63 | 28-Sep-17 | 9-Nov-17 | 817 Arncote Ave | Form & Character - 5 Townhouses |
| 66 | DP-17-64 | 3-Oct-17 | 14-Nov-17 | 720, 724 & 732 Meaford Ave; 2844 Millstream Rd | Form & Character - 6-Storey, 106 Unit Rental Apartment Building |
| 67 | DP-17-65 | 4-Oct-17 | 25-Oct-17 | 1189 Goldstream Ave | Environmental - Addition of a Deck |
| 68 | DP-17-66 | 3-Oct-17 | 3313 - 3332 Sanderling Way; 903, 911, 915 Tayberry Terr | Form & Character - Vinyl on 3 Rear Sides; Cedar and Hardy on Front for all 26 Units | |
| 69 | DP-17-67 | 17-Oct-17 | On Hold | 2768 Sooke Rd | Environmental/Hazardous - SFD within Approved Building Envelope |
| 70 | DP-17-68 | 19-Oct-17 | 9-Nov-17 | 821 Hockley Ave (consolidated 819 & 823 Hockley Ave) | Form & Character - 72 Unit Apartment Building |
| 71 | DP-17-69 | 24-Oct-17 | 23-Nov-17 | 960 Division Ave (3061 Jacklin Rd - Old Belmont School Site) | Form & Character - 80 Unit Residential Building |
| 72 | DP-17-70 | 25-Oct-17 | 25-Oct-17 | 3532 Grenadier Rd | Amend a Side Yard Setback |
| 73 | DP-17-71 | 3-Nov-17 | 745 Treanor Ave | Environmental - Gazebo Construction within a Riparian DP Area | |
| 74 | DP-17-72 | 27-Oct-17 | 1497 Pebble Pl | Amends DP-16-36 - Combustible Exterior Building Materials - Fire Interface Hazard | |
| 75 | DP-17-73 | 31-Oct-17 | 1085 Goldstream Ave | Form & Character - 5-Storey, 166 Unit Apartment Building | |
| 76 | DP-17-74 | 17-Nov-17 | 22-Dec-17 | 1290 Langford Pkwy | Form & Character - Storage Garage and surface parking at grade |
| 77 | DP-17-75 | 21-Nov-17 | 14-Sep-17 | 525 & 529 Langvista Dr | Environmental - 6 SFD Strata Lots |
| 78 | DP-17-76 | 20-Nov-17 | 2874 Leigh Rd | Form & Character - Residence with Detached Cottage | |
| 79 | DP-17-77 | 21-Nov-17 | 866 Latoria Rd | Environmental & Form & Character - 30 Unit Townhouse and 18 SFD Development | |
| 80 | DP-17-78 | 20-Nov-17 | 3003 Irwin Rd - Westhills Nova Lands Ph 8 | Form & Character - SFD and Multi-Family Residential Subdivision | |
| 81 | DP-17-79 | 29-Nov-17 | 2668 Sooke Rd | Capacity increase | |
| 82 | DP-17-80 | 29-Nov-17 | 2835 Bryn Maur Rd | Amended hours | |
| 83 | DP-17-81 | 5-Dec-17 | 2323 Millstream Rd | Axe and Barrel | |
| 84 | DP-17-82 | 6-Dec-17 | 13-Dec-17 | 737 Goldstream Ave | Darcy's Pub |
| 85 | DP-17-83 | 13-Dec-17 | 917 Avrill Rd | Cherish at Central Park - Liquor License | |
| 86 | DP-17-84 | 19-Dec-17 | 1020 Deltana Ave | Form & Character - Carriage House | |
| 87 | DP-17-85 | 15-Dec-17 | 632 Goldstream Ave | 6 units | |
| 88 | DP-17-86 | 19-Dec-17 | 2780 Millstream Rd | 6 units | |
| 89 | DP-17-87 | 20-Dec-17 | 920 Dunford | 7 Townhouses | |
| 90 | DP-17-88 | 22-Dec-17 | 3019 & 3023 Constellation Ave | Environmental - Rock Crushing Operation | |
| 91 | DP-17-89 | 27-Dec-17 | 27-Dec-17 | 3338, 3340 & 3344 Happy Valley Rd | Form & Character - 37 Unit Townhouse Development |
| 92 | DVP-17-01 | 19-Jan-17 | 20-Mar-17 | 881 Klahanie Dr | North, South, and Easterly Lot line Variances for Deck Projection |
| 93 | DVP-17-02 | 23-Jan-17 | 20-Mar-17 | 2000 Hannington Rd | To Allow a Parking Count of 289 Spaces |
| 94 | DVP-17-03 | 27-Jan-17 | 3-Apr-17 | 2267 Nicklaus Dr | To Reduce Rear Lot Line and Deck Projection |
| 95 | DVP-17-04 | 20-Feb-17 | 17-Jul-17 | 2023 Millstream Rd | Reduce the Requirement for Sewer and Potable Water |
| 96 | DVP-17-05 | 16-Mar-17 | Withdrawn | 2190 & 2220 Spirit Ridge Dr | Bylaw 1000 Variance for 2-Point Turn-Around Rather than the Required Cul-de-Sac |
| 97 | DVP-17-06 | 24-Mar-17 | 18-Sep-17 | 2926 Leigh Pl | Riparian, detached Building and Non-Conforming Setbacks |
| 98 | DVP-17-07 | 29-Mar-17 | 17-Jul-17 | 2213 Navigators Rise | Height Variance |
| 99 | DVP-17-08 | 6-Apr-17 | 17-Jul-17 | 890 Bear Mountain Pkwy | 3 Rear Lot Setback Reductions |
| 100 | DVP-17-09 | 10-Apr-17 | 17-Aug-17 | 3296 Jacklin Rd | Rear and Front Setback Variances |
| 101 | DVP-17-10 | 24-Apr-17 | 15-May-17 | 2840 Sooke Lk Rd | Onsite Parking and Setback Reductions |
| 102 | DVP-17-11 | 25-Apr-17 | 17-Jul-17 | (Lakepoint Way) 1220 Parkdale Dr, 3210 West Shore Pkwy & 1290 Langford Pkwy | Vary Parking Stall Requirement |
| 103 | DVP-17-12 | 2-May-17 | Centre Mountain Properties - PIDs 001-703-374, 018-034-187, 018-034-195, 018-034-209; 2961, 2965, 2983, 3005, 3012 Sooke Rd; 1241, 1261 Cogan Rd; 3690, 3694 Happy Valley Rd | Bylaw 1000 Variance - Frontage Improvements or Municipal Sewer System Connection in BP8 Zone | |
| 104 | DVP-17-13 | 2-May-17 | 17-Jul-17 | 2614 Sooke Rd | Variance on Parking Stalls |
| 105 | DVP-17-14 | 15-May-17 | 14-Aug-17 | 1488 Pebble Pl | Rear Yard Setback for a Covered Patio |
| 106 | DVP-17-15 | 19-May-17 | 17-Jul-17 | 2363 Setchfield Ave, 626 Hoylake Ave & 3291 Happy Valley Rd | Portable Installations |
| 107 | DVP-17-16 | 13-Jun-17 | 1051 Braeburn Ave | Vary Emergency Access Requirement | |
| 108 | DVP-17-17 | 16-Jun-17 | 2895 West Shore Pkwy | Vary Front Lot Line | |
| 109 | DVP-17-18 | 16-Jun-17 | 18-Sep-17 | 3059 & 3061 Jacklin Rd | Vary Sign Bylaw for More Freestanding Signs |
| 110 | DVP-17-19 | 12-Jul-17 | 2-Oct-17 | 2824 Knotty Pine Rd | Interior and Rear Lot Line Variances |
| 111 | DVP-17-20 | 8-Aug-17 | 2-Oct-17 | 2207 Millstream Rd | Waive of Fee Request and Freestanding Daycare Signage |
| 112 | DVP-17-21 | 11-Aug-17 | 16-Oct-17 | 2174 Bellamy Rd | Lot Width Variance and Side Yard setbacks for 1 SFD and 1 Duplex |
| 113 | DVP-17-22 | 23-Aug-17 | 16-Oct-17 | 721 Station Ave | New Freestanding Signage |
| 114 | DVP-17-23 | 13-Sep-17 | 2579 Rainville Rd | Vary Rear Setbacks | |
| 115 | DVP-17-24 | 15-Sep-17 | 20-Nov-17 | 2647 Crystalview Dr | Vary Rear and Exterior Setbacks and Lot Width |
| 116 | DVP-17-25 | 20-Sep-17 | Withdrawn | 3306, 3310 , 3326, 3328 Happy Valley Rd | Vary On-Site Parking |
| 117 | DVP-17-26 | 27-Sep-17 | 1345 Ravensview Dr | Exceeds Maximum Size | |
| 118 | DVP-17-27 | 2-Oct-17 | 3143 Jacklin Rd | Interior Setback Reduction to Maximize Parking | |
| 119 | DVP-17-28 | 16-Oct-17 | 3690 Happy Valley Rd | Panhandle Lot | |
| 120 | DVP-17-29 | 16-Nov-17 | 1431 Grand Forest Cl | Bylaw 1000 Variance - Cul-de-Sac Length | |
| 121 | DVP-17-30 | 15-Nov-17 | 2401 Millstream Rd | Variance for Two Freestanding Signs | |
| 122 | DVP-17-31 | 20-Nov-17 | 2874 Leigh Rd | Side Yard (Flute Ln) for New SFD | |
| 123 | DVP-17-32 | 24-Nov-17 | SDP instead | 3061 & 3067 Jacklin Rd | Vary Sign Bylaw - 3 Freestanding Signs |
| 124 | DVP-17-33 | 13-Dec-17 | 1445 Bear Mountain Pky | Vary cul-de-sac | |
| 125 | LLP17-0001 | 8-Jun-17 | 17-Jul-17 | 917 Avril Rd | Cherish at Central Park |
| 126 | LLP17-0002 | 23-Aug-17 | 2903 Sooke Rd | Ma Miller's Pub | |
| 127 | LLP17-0003 | 10-Oct-17 | 101 - 1325 Bear Mountain Pkwy | Twist Salon | |
| 128 | LLP17-0004 | 27-Oct-17 | 761 Station Ave | Royal Canadian Legion Prince Edward Branch #91 | |
| 129 | SDP-17-01 | 10-Jan-17 | 13-Jan-17 | #153 - 2401C Millstream Rd | 1 Façade - Rogers |
| 130 | SDP-17-02 | 26-Jan-17 | 2-Feb-17 | #207 - 859 Orono Ave | 1 Façade - Consolidated Civil Enforcement |
| 131 | SDP-17-03 | 2-Feb-17 | 2-Feb-17 | #113 - 693 Hoffman Ave | 1 Façade - 9 Round 30 Minute Kickbox Fitness |
| 132 | SDP-17-04 | 10-Feb-17 | 22-Feb-17 | 752B Goldstream Ave | 1 Façade - Easy Financial |
| 133 | SDP-17-05 | 24-Feb-17 | 1-Mar-17 | 850 Langford Pkwy | 5 Façade - Lowe's |
| 134 | SDP-17-06 | 27-Feb-17 | 1-Mar-17 | 748 Goldstream Ave | 1 Façade - Expedia Cruise Ship Centers |
| 135 | SDP-17-07 | 28-Feb-17 | 7-Mar-17 | 895 Goldstream Ave | 1 Façade - Bumper to Bumper |
| 136 | SDP-17-08 | 28-Feb-17 | 2-Mar-17 | #137 - 777 Goldstream Ave | 1 Façade - Modus Physiotherapy |
| 137 | SDP-17-09 | 9-Mar-17 | #406 - 2945 Jacklin Rd | 2 Façade - Chatters Hair and Beauty Salon | |
| 138 | SDP-17-10 | 7-Apr-17 | 11-Apr-17 | 835 Langford Pkwy | 5 Façade - Real Canadian Superstore |
| 139 | SDP-17-11 | 20-Apr-17 | 27-Apr-17 | 725 Goldstream Ave | 1 Façade - City Wide Scooter/The Walkin Tub Company |
| 140 | SDP-17-12 | 26-Apr-17 | 27-Apr-17 | 2920 Amy Rd | 3 Façade - U-Pak Mobile Mini Storage Ltd. |
| 141 | SDP-17-13 | 8-May-17 | 11-May-17 | 2945 Jacklin Rd | 2 Façade - Purdy's Chocolates |
| 142 | SDP-17-14 | 17-May-17 | 23-May-17 | 137 - 777 Goldstream Ave | 1 Sandwich Board - Motus Physiotherapy |
| 143 | SDP-17-15 | 24-May-17 | 2207 Millstream Rd | 1 Freestanding - Westshore Alliance Church | |
| 144 | SDP-17-16 | 26-May-17 | 29-May-17 | #143 - 2401C Millstream Rd | 1 Façade - An's Nails |
| 145 | SDP-17-17 | 29-May-17 | 5-Jun-17 | 748 Goldstream Ave | 1 Façade - Expedia Cruise Ship Centers |
| 146 | SDP-17-18 | 1-Jun-17 | 1-Jun-17 | 850 Langford Pkwy | 1 Façade - Lowe's |
| 147 | SDP-17-19 | 31-May-17 | 5-Jun-17 | #169 - 2401C Millstream Rd | 1 Façade - Millstream Veterinary Hospital |
| 148 | SDP-17-20 | 13-Jun-17 | 19-Jun-17 | 2945 Jacklin Rd | 1 Façade - Carters/Osh Kosh |
| 149 | SDP-17-21 | 16-Jun-17 | #104 - 2806 Jacklin Rd | 1 Façade - Pacific Rim Interiors | |
| 150 | SDP-17-22 | 20-Jun-17 | #114 - 2806 Jacklin Rd | 2 Façade - Universal Supplements & L.A. Tanning | |
| 151 | SDP-17-23 | 21-Jun-17 | 28-Jun-17 | #117 - 662 Goldstream Ave | 1 Façade - MSR Solutions |
| 152 | SDP-17-24 | 12-Jul-17 | 17-Jul-17 | #169 - 2401C Millstream Rd | 1 Sandwich Board - Millstream Veterinary Hospital |
| 153 | SDP-17-25 | 26-Jul-17 | 9-Aug-17 | #193 - 2401C Millstream Rd | 2 Façade - Persimmon Tree Restaurant |
| 154 | SDP-17-26 | 26-Jul-17 | 26-Jul-17 | 985 Whirlaway Cres | 4 Façade - Mr. Mikes Steakhouse |
| 155 | SDP-17-27 | 10-Aug-17 | 21-Aug-17 | 850 Langford Pkwy | 1 Projecting & 1 Other - Rona Converting to Lowe's Hardware and Lumber Retail |
| 156 | SDP-17-28 | 11-Aug-17 | 28-Sep-17 | 2865 Peatt Rd | 1 Façade - Bloom Montessori Langford Preschool |
| 157 | SDP-17-29 | 22-Aug-17 | 23-Aug-17 | 3059 & 3061 Jacklin Rd | 2 Temporary - Belmont Market Retail Development |
| 158 | SDP-17-30 | 6-Sep-17 | 12-Sep-17 | 768 Goldstream Ave | 1 Façade - La Taquisa Mexican Restaurant |
| 159 | SDP-17-31 | 7-Sep-17 | 26-Sep-17 | 130-2945 Jacklin Rd | 1 Façade - Mastermind Toys |
| 160 | SDP-17-32 | 14-Sep-17 | 15-Sep-17 | 717 Goldstream Ave | 1 Façade - Pacific Coast Cremation |
| 161 | SDP-17-33 | 14-Sep-17 | 15-Sep-17 | 715 Goldstream Ave | 1 Façade - Academy of Learning |
| 162 | SDP-17-34 | 20-Sep-17 | 20-Sep-17 | 616 Goldstream Ave | 1 Freestanding - Pacifica Housing |
| 163 | SDP-17-35 | 2-Oct-17 | 12-Oct-17 | #140 - 1047 Langford Pkwy | 1 Sandwich Board - The Rising - Victoria Centre for Circus Arts |
| 164 | SDP-17-36 | 27-Oct-17 | 2-Nov-17 | 2785 Leigh Rd | 1 Façade - Sasco Contractors Ltd. |
| 165 | SDP-17-37 | 20-Oct-17 | 31-Oct-17 | 721 Station Ave | 1 Freestanding - Shoreline Orthodontics |
| 166 | SDP-17-38 | 24-Oct-17 | 31-Oct-17 | #125 - 877 Goldstream Ave | 1 Sandwich Board - DFH Real Estate Ltd |
| 167 | SDP-17-39 | 25-Oct-17 | 3-Nov-17 | #117 - 735 Goldstream Ave | 1 Façade - Soulful Sister Aromatherapy |
| 168 | SDP-17-40 | 2-Nov-17 | 791 Goldstream Ave | 1 Façade - Vancouver Island Sheet Metal Workers Local 276 | |
| 169 | SDP-17-41 | 1-Nov-17 | 5-Dec-17 | 2401 Millstream Rd | Directional - Millstream Village |
| 170 | SDP-17-42 | 22-Nov-17 | 22-Nov-17 | #110 - 582 Goldstream Ave | 1 Façade - St Anthony's Dental Clinic |
| 171 | SDP-17-43 | 22-Nov-17 | 22-Nov-17 | #123 - 2745 Veterans Memorial Pkwy | 1 Façade - Hemminger Law Group Westshore |
| 172 | SDP-17-44 | 22-Nov-17 | Withdrawn | 1256 Landing Lane | 1 Freestanding - Aqua Langford Lake |
| 173 | SDP-17-45 | 24-Nov-17 | 14-Dec-17 | 2805 Carlow Rd | 2 Façade, 1 Freestanding - Centennial Centre for Arts, Culture and Community |
| 174 | SDP-17-46 | 24-Nov-17 | 14-Dec-17 | 759 McCallum Rd | 3 Façade - Save on Foods |
| 175 | SDP-17-47 | 19-Dec-17 | 11-Dec-17 | 1152 Lippincott Rd | Environmental - fill for top soil farm use |
| 176 | SDP-17-48 | 28-Dec-17 | 28-Dec-17 | 202-2800 Bryn Maur Rd | Façade - Sooke Family Resource Centre Councillors |
| 177 | OCP-17-01 | 21-Feb-17 | 15-May-17 | Centre Mountain Properties | New Boundary Adjustment from Metchosin |
| 178 | OCP-17-02 | 27-Sep-17 | 866 Latoria Rd | AG1 to Neighbourhood | |
| 179 | OCP-17-03 | 3-Oct-17 | 6-Nov-17 | 976 Dunford Ave | Neighbourhood to City Centre |
| 180 | OCP-17-04 | 17-Oct-17 | Closed | 3130 Jacklin Rd | R2 to RM7A - 3 to 5 Storey Wood Framed Rental Apartment Building |
| 181 | OCP-17-05 | 8-Aug-17 | 790 McCallum Rd | Neighbourhood to Mixed Use Employment Centre | |
| 182 | OCP-17-06 | 17-Aug-17 | 2869 Sooke Rd Road Closure Portion | Neighbourhood to Business or Light Industrial | |
| 183 | OCP-17-07 | 24-Aug-17 | 16-Oct-17 | Omnibus Amendments to Map 2 – Growth Management & Land Use | Omnibus Amendments to Map 2 – Growth Management and Land Use Strategy |
| 184 | OCP-17-08 | 13-Dec-17 | 2682, 2684, 2686, 2696, 2702, 2706 Sooke Rd | Neighbourhood/Neighbourhood Centre to Village Centre | |
| 185 | TUP-17-01 | 17-Jan-17 | 20-Feb-17 | 721 Station Ave | Orthodontics Office |
| 186 | TUP-17-02 | 29-Apr-97 | 2-Jun-97 | 1297 Glenshire Dr & 2929 Sooke Rd | Processing and Removal of Aggregate, Storage of Aggregate |
| 187 | TUP-17-03 | 31-Jul-00 | 14-Aug-17 | 2945 Jacklin Rd | Hyundai Showroom |
| 188 | Z-17-01 | 17-Jan-17 | 8-Jun-17 | 903 Tayberry Terr | Amend CD10 Zone - Remove Requirement of 4 Rentals in the Rental Agreement |
| 189 | Z-17-02 | 1-Feb-17 | 767, 769 & 771 Hockley Ave | R1 to MU2 - 6 Storey Apartment Building | |
| 190 | Z-17-03 | 14-Feb-17 | 19-Jun-17 | 3039 Glen Lake Rd | R2 Text Amendment to Permit a Carriage House |
| 191 | Z-17-04 | 10-Feb-17 | 17-Jul-17 | 1319 & 1323 Ravensview Dr | RR4 Text Amendment - Smaller Parcel Sizes to Allow a 3 Lot Subdivision |
| 192 | Z-17-05 | 21-Feb-17 | 15-May-17 | Centre Mountain Properties - PIDs 001-703-374, 018-034-187, 018-034-195, 018-034-209; 2961, 2965, 2983, 3005, 3012 Sooke Rd; 1241, 1261 Cogan Rd; 3690, 3694 Happy Valley Rd | New Boundary Adjustment from Metchosin |
| 193 | Z-17-06 | 23-Feb-17 | Withdrawn | 2579 Rainville Rd | Text Amendment for a Detached Suite |
| 194 | Z-17-07 | 28-Feb-17 | 16-Oct-17 | 1253 Goldstream Ave | To RS4 - 4 Lot Subdivision with Secondary Suites |
| 195 | Z-17-08 | 9-Mar-17 | 8-Jun-17 | Omnibus No. 45 - Care Facilities | Omnibus No. 45 - to Allow Community Care Facilities in the M1 Zone |
| 196 | Z-17-09 | 10-Mar-17 | 1-May-17 | Omnibus No. 46 - Liquor Store Licenses | Omnibus No. 46 - Liquor Store Licenses |
| 197 | Z-17-10 | 31-Mar-17 | 19-Jun-17 | 3690 & 3694 Happy Valley Rd | RR2 to RS4 for a 55 Lot Subdivision |
| 198 | Z-17-11 | 17-Mar-17 | 5-Sep-17 | 656 Frederic Rd and 765 Willing Dr | To RR6A for 53 Lots of 550 m2 |
| 199 | Z-17-12 | 22-Mar-17 | 2670 Peatt Rd & 813 Arncote Ave | Rezone to Accommodate 32 Condo Units | |
| 200 | Z-17-13 | 24-Mar-17 | 18-Sep-17 | 3130 Jacklin Rd | R2 to RM7A - 3 to 5 Storey Wood Framed Rental Apartment Bldg |
| 201 | Z-17-14 | 27-Mar-17 | 17-Jul-17 | 731 Station Ave | To MU1A - 55 Units with 600 m2 Commercial Office Space |
| 202 | Z-17-15 | 28-Mar-17 | 16-Oct-17 | 3343, 3347 & 3359 Luxton Rd | 8 Small Lots and 72 Townhouse Units |
| 203 | Z-17-16 | 28-Mar-17 | 866 Latoria Rd | To RR6 - 25 Single Family Lots | |
| 204 | Z-17-17 | 7-Apr-17 | Omnibus No. 47 - Carriage Houses in 1 Acre Plus Lots | Carriage Houses on Lots 1 Acre or Greater | |
| 205 | Z-17-18 | 10-Apr-17 | 14-Aug-17 | 2148 & 2150 Millstream Rd | To CH4 or RT1 for Townhouse Development |
| 206 | Z-17-19 | 10-Apr-17 | 1300 Glenshire Dr | RR4 to RM2A for 100 Townhouse Units | |
| 207 | Z-17-20 | 25-Apr-17 | 6-Nov-17 | 1177 Goldstream Ave | To RM2A - Construction of a Tri-plex Townhouse |
| 208 | Z-17-21 | 25-Apr-17 | 1184 Goldstream Ave | To RM2A - Triplex Townhouse Complex | |
| 209 | Z-17-22 | 1-May-17 | 6-Nov-17 | 976 Dunford Ave | RR4 to MU1A for a 4 Storey Condominium Building |
| 210 | Z-17-23 | 2-May-17 | 2-Oct-17 | 2839 Jacklin Rd, 862, 864 & 866 Orono Ave | Consolidation and Subdivision for the Development of Two Separate Lots; One Lot With 78-Units Rental Building and the Other Lot With a 45-Unit Rental Building |
| 211 | Z-17-24 | 17-May-17 | 2500 Echo Valley Dr | CD6 to R2 | |
| 212 | Z-17-25 | 24-May-17 | 967 Walfred Rd | R2 to RS3 for 5 small Lot Subdivision | |
| 213 | Z-17-26 | 25-May-17 | 813 & 817 Orono Ave | MU1A for 14 Unit Strata Development | |
| 214 | Z-17-27 | 29-May-17 | Westhills Development - all properties | CD3 Text Amendment | |
| 215 | Z-17-28 | 31-May-17 | 16-Oct-17 | 2874 Leigh Rd | R1 Text Amendment - Permit a Detached Secondary Suite |
| 216 | Z-17-29 | 31-May-17 | 1067 & 1077 Goldstream Ave | To MU1A - Townhouse Development | |
| 217 | Z-17-30 | 5-Jun-17 | 2-Oct-17 | 732 Meaford Ave | To MU1A for a 6-Storey Rental Apartment |
| 218 | Z-17-31 | 6-Jun-17 | 934 Goldstream Ave | CS1 Text Amendment to Add Funeral Home as a Permitted Use | |
| 219 | Z-17-32 | 5-Jul-17 | 5-Sep-17 | 2741, 2749, 2751, 2753, 2757 & 2761 Spencer Rd; 996 Preston Way | Omnibus No. 48 - To MU1A - Road Closure Portion and Text Amendment to MU1A |
| 220 | Z-17-33 | 12-Jul-17 | 6-Nov-17 | 4342 West Shore Pkwy (formerly 1312 Glenshire Dr) | Future Residential Development |
| 221 | Z-17-34 | 12-Jul-17 | 20-Nov-17 | 2955 Irwin Rd | 18 Lot Subdivision |
| 222 | Z-17-35 | 2-Aug-17 | 20-Nov-17 | 681 Rockingham Rd | To RS1 - 3-Lot Subdivision and Text Amendment for House Size |
| 223 | Z-17-36 | 3-Aug-17 | 798 Goldstream Ave; 2747, 2753, 2761, 2769 & 2779 Peatt Rd; 2734, 2738, 2738, 2742, 2746, 2750 & 2756 Claude Rd | Catholic Church Comprehensive Development | |
| 224 | Z-17-37 | 8-Aug-17 | 790 McCallum Rd (City Gate) | Creation of a New Comprehensive Zone | |
| 225 | Z-17-38 | 9-Aug-17 | Withdrawn | 3429 & 3431 Luxton Rd | RR4 to RS3 - 16 Single-Family Strata Lots |
| 226 | Z-17-39 | 22-Aug-17 | 2636, 2640 & 2646 Peatt Rd; 808, 812 & 820 Arncote Ave; 2641, 2647 & 2649 Sunderland Rd | 12 Storey - 222 Unit with Penthouse Building | |
| 227 | Z-17-40 | 24-Aug-17 | 6-Nov-17 | 694 Goldstream Ave and 688 Granderson Rd | C3 to C8 to Legalize Apartments over Commercial |
| 228 | Z-17-41 | 29-Aug-17 | 721 Station Ave | New Zone for Future Development | |
| 229 | Z-17-42 | 12-Sep-17 | 2844 Millstream Rd | To MU1A | |
| 230 | Z-17-43 | 26-Sep-17 | Omnibus No. 49 | Crematoriums and Various Other Amendments | |
| 231 | Z-17-44 | 13-Oct-17 | 1256 Landing Lane | CD1 Text Amendment | |
| 232 | Z-17-45 | 17-Oct-17 | Omnibus No. 50 | Downtown Parking | |
| 233 | Z-17-46 | 7-Nov-17 | 804 Latoria Rd & 950 Worrall Dr | Rezone to RS4 - 342 Lot Subdivision and 70 Townhomes | |
| 234 | Z-17-47 | 8-Nov-17 | Withdrawn | 2792 Winster Rd | Rezone to Allow a 4 Unit Townhome Development |
| 235 | Z-17-48 | 14-Nov-17 | 854 Latoria Rd | Rezone to Allow for a 9-lot Residential Subdivision | |
| 236 | Z-17-49 | 13-Oct-17 | 1256 Landing Lane | CD1 Text Amendment | |
| 237 | Z-17-50 | 17-Oct-17 | Omnibus No. 50 | Downtown Parking | |
| 238 | Z-17-51 | 7-Nov-17 | 804 Latoria Rd & 950 Worrall Dr | Rezone to RS4 - 342 Lot Subdivision and 70 townhomes |
(End of Applications table excerpt reproduced from pages 26–33 of report.)
Land Development / Approving Officer
Average Processing Time (Number of Days) — Approving Officer
| Year | 1st Quarter | 2nd Quarter | 3rd Quarter | 4th Quarter |
|---|---|---|---|---|
| 2012 | 29.6 | 77.6 | 72.8 | 79.9 |
| 2013 | 60.2 | 36.6 | 57.1 | 42.5 |
| 2014 | 51.0 | 57.5 | 33.8 | 43.0 |
| 2015 | 78.6 | 63.8 | 45.8 | 48.7 |
| 2016 | 57.6 | 42.4 | 35.75 | 29.33 |
| 2017 | 40.7 | 37.8 | 39.4 | 30.8 |

Subdivision Activity (Number of Lots) — Lots Under Consideration (Year to Date)
- Lots Under Consideration 1st Quarter: 174
- Lots Under Consideration 2nd Quarter: 204
- Lots Under Consideration 3rd Quarter: 127
- Lots Under Consideration 4th Quarter: 149
- Year To Date: 654
Subdivision Revenue (Account)
| Account | Budget 2017 | 2017 | Variance |
|---|---|---|---|
| 10-02-115-472-0000-0078 – Subdivision Application Fees | $205,000 | 195,652 | $9,348 |
| 10-02-115-472-0000-0079 – Subdivision Final Approval | $65,000 | $49,642 | $15,358 |
| 10-02-115-472-0000-0080 – Strata Conversion Applications | $2,000 | $2,835 | $835 |
| 10-02-115-472-0000-0081 – Subdivision Onsite Eng Approval | $100,000 | $83,375 | $16,625 |
| 10-02-150-472-0000-0548 – Latecomer Processing Charges | $1,000 | $0 | $1,000 |
Subdivision Applications Received (Selected entries)
(A full listing of subdivision application entries is presented in the report; examples below are reproduced.)
| Sub Number | Location | Status | Application Date | SOC Issued Date | # of Lots |
|---|---|---|---|---|---|
| SUB17-0063 | 4342 West Shore Pkwy | Subdivision | 29-Dec-2017 | 1 | |
| SUB17-0062 | 2250 Bear Mountain Pkwy (Seacliff) | Subdivision | 14-Dec-2017 | 32 | |
| SUB17-0061 | 1445, 1450, 1950 Bear Mountain Pkwy, 2118, 2133 Champions Way | Subdivision | 11-Dec-2017 | 10 | |
| SUB17-0060 | 1270, 1950 Bear Mountain Pky, 2030 Country Club Way, 1294 Academy Way | Subdivision | 11-Dec-2017 | 15 | |
| SUB17-0059 | 924 Walfred Rd | Subdivision | 30-Nov-2017 | 9 | |
| SUB17-0058 | Bear Mountain, Phase 10 | Amenity Lot | 28-Nov-2017 | n/a | 1 |
| SUB17-0057 | 1311 Lakepoint Way | Road Dedication | 27-Nov-2017 | n/a | 0 |
| SUB17-0056 | 681 Rockingham Rd | Subdivision | 21-Nov-2017 | 2 |
(Full Subdivision Applications listing continues in the report. See pages 34–36 for complete table.)
Consolidated Financial Statements 2017
[Section heading included; full consolidated financial statements and detailed schedules appear in the original report pages 37–56.]
Permissive Tax Exemptions
[Section heading included; details and listings of permissive tax exemptions appear in the original report pages 58–59.]
Annual Development Cost Charge
[Section heading included; the Annual Development Cost Charge details appear on page 63 of the original report.]
End of extracted content for pages 3–65.
